SPP’s Planning Framework Enters Its Next Phase: CPP Phase 2, a Unified Data Portal, and IEEE 1547 Guidance Point Toward Faster Studies, Cleaner Model Data, and Clearer DER Performance Expectations

(Key takeaways from the Aug. 25–26, 2026 Joint ESWG–TWG meeting  |  By RMS Energy )

THE CENTRAL SHIFT: SPP is redesigning not only what gets studied, but how projects enter the planning process, how model data is submitted, and how distributed-energy-resource performance expectations are translated into regional guidance.

Three initiatives, one operating theme

1. CPP Phase 2 adds a speed-to-power lane

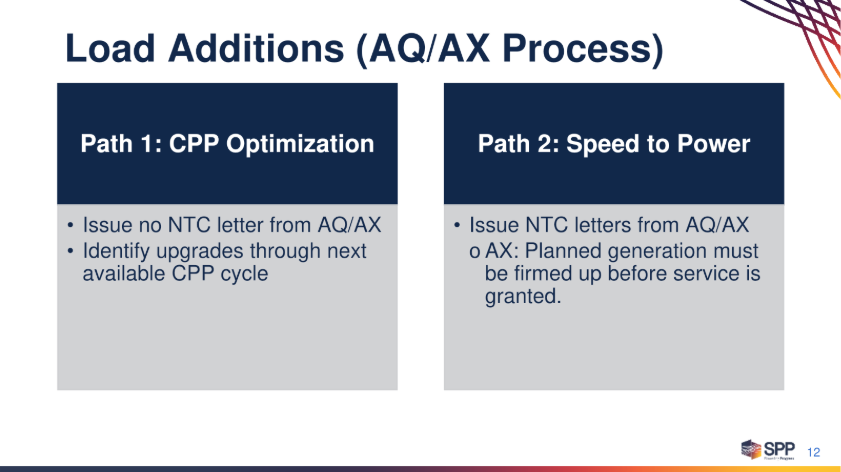

For transmission service, SPP proposes two Aggregate Transmission Service Study cycles. Cycle 1 would align with the CPP Integrated Conceptual Study window and feed the optimization process. Cycle 2 would occur in the second half of the CPP cycle as an off-cycle route for urgent resource-adequacy needs and congestion hedging, with Notifications to Construct expected after that study concludes.

2. The Unified Submission Portal treats data quality as schedule certainty

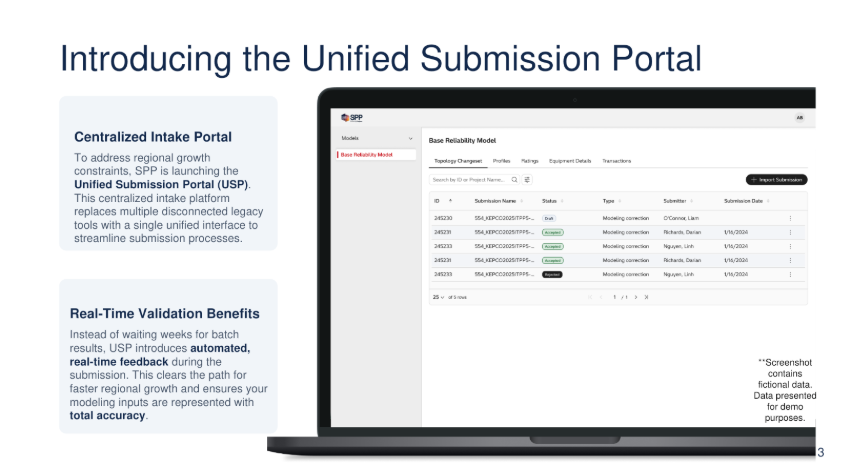

Figure 2. The Unified Submission Portal is intended to centralize intake and provide real-time validation before model data enters downstream studies.

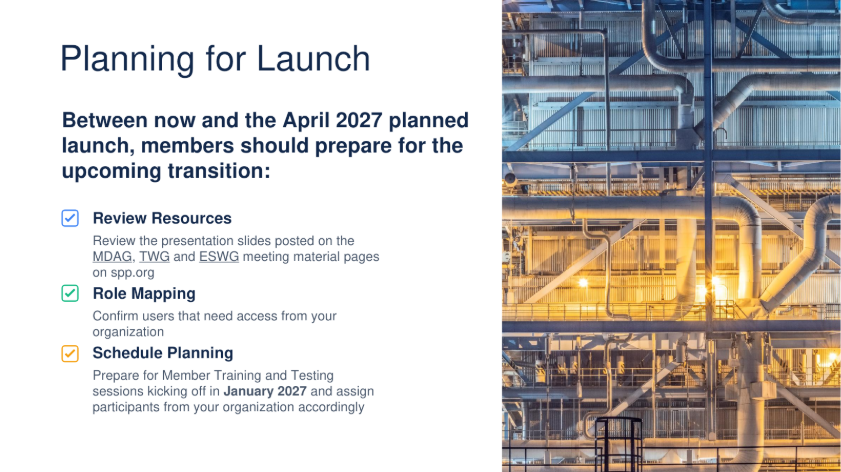

Figure 3. SPP is asking members to prepare users and schedules ahead of the planned April 2027 portal launch.

Member training and testing are expected to begin in January 2027, followed by a planned April 2027 launch. Organizations should use the intervening months to identify portal users, map responsibilities, standardize internal review, and clean recurring data-quality issues before they reach SPP’s validation layer.

3. IEEE 1547 guidance brings DER behavior into regional reliability planning

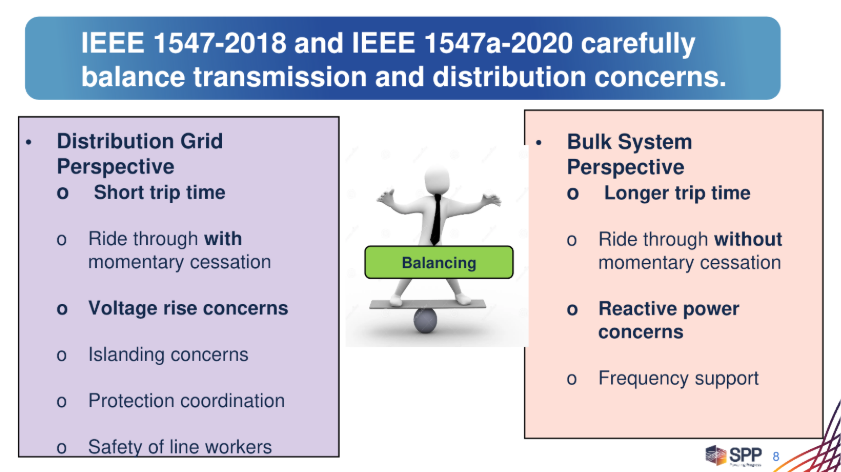

Figure 4. SPP’s recommendations must balance distribution-system protection and safety with bulk-system ride-through, reactive-power, and frequency-support needs.

The standards represent a meaningful evolution. Earlier requirements emphasized tripping during abnormal voltage or frequency conditions; the 2018 standard requires DER capability for voltage regulation, ride-through, and frequency response, while the 2020 amendment adds flexibility for Category III voltage ride-through settings.

SPP’s guideline and Technical Interconnection and Interoperability Requirements are being developed as recommendations, not mandatory or enforceable requirements. Working-group review is planned through the third and fourth quarters of 2026, approvals are targeted for the first quarter of 2027, and MOPC consideration is shown for April 2027. Stakeholder comments are requested by Sept. 10, 2026

What stakeholders should do now

  • Prepare for the portal transition. Assign USP roles, inventory recurring submissions, and resolve data-quality issues before member testing begins.
  • Review DER settings and contracts. Compare ride-through, protection, reactive-power, and frequency-response practices with the proposed regional guidance.
  • Engage while the details are open. Use the stakeholder process—particularly the Sept. 10 IEEE-comment deadline—to flag implementation and coordination concerns.

RMS Energy perspective

For developers and transmission customers, the practical advantage will come from integrating planning, data governance, equipment settings, commercial commitments, and stakeholder engagement before a request reaches the formal study queue. The organizations that prepare those pieces together will be best positioned to use SPP’s evolving framework effectively.

#SPP  #TransmissionPlanning  #GridReliability  #LargeLoads  #DER  #IEEE1547  #EnergyTransition  #RMSEnergy
