SPP 2026 ITP: 765 kV Overlay, Load Growth and the Cost of Delay

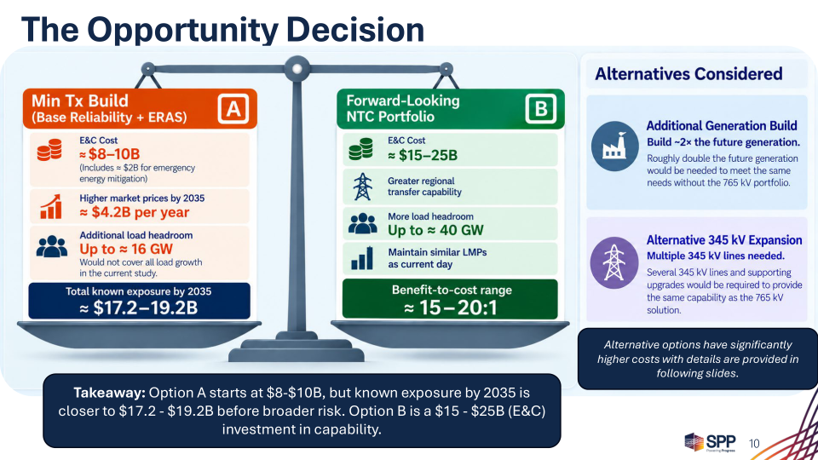

Minimum build vs. a forward-looking portfolio

  • Minimum build: about $8-$10 billion in E&C cost, with total known exposure by 2035 estimated at roughly $17.2-$19.2 billion.
  • SPP’s education material shows an estimated benefit-to-cost range of about 15-20:1 for the forward-looking option.

Source: SPP, “2026 ITP and CPP Transition Study – MOPC Education Session,” Sept. 11, 2026, slide 10.

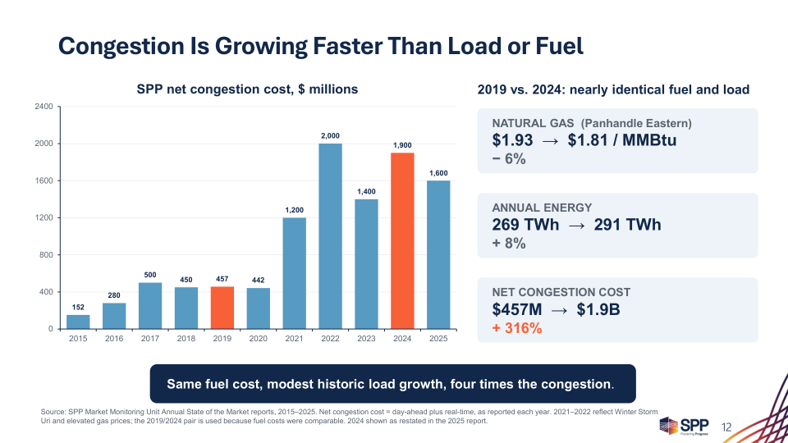

Congestion is already changing the planning baseline

Source: SPP, “2026 ITP and CPP Transition Study – MOPC Education Session,” Sept. 11, 2026, slide 12.

Load growth is translating into more system needs

Why SPP is emphasizing 765 kV

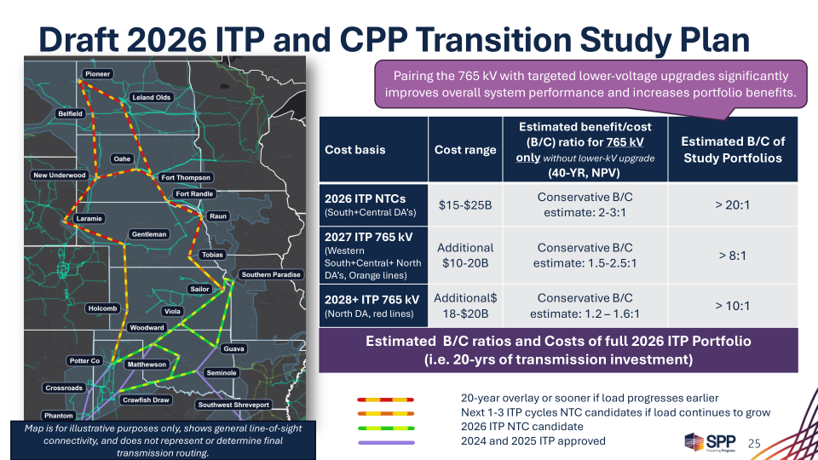

Draft portfolio economics and transition plan

Source: SPP, “2026 ITP and CPP Transition Study – MOPC Education Session,” Sept. 11, 2026, slide 25.

Decision timeline

RMS Energy perspective
