MISO’s Planning Picture: $73B in Active Projects, Changing Transfer Limits, and the Next LRTP Models

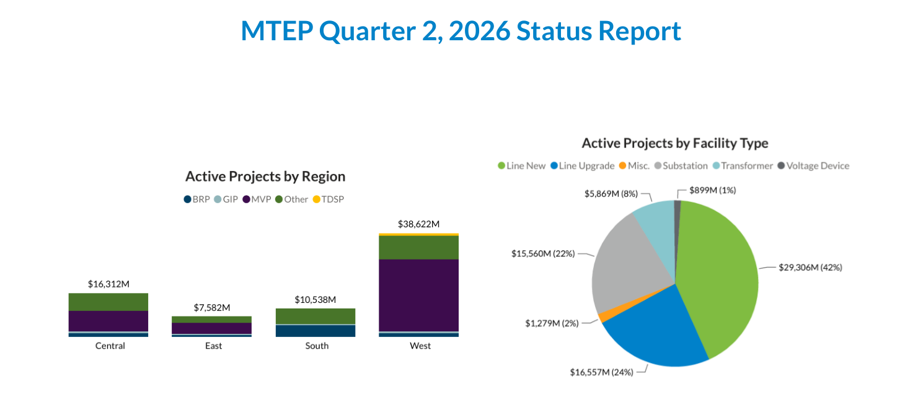

1. MISO is carrying a $73.1 billion active transmission portfolio

Source: MISO, “MTEP Approved Project Quarterly Status Reporting,” Planning Subcommittee, Sept. 2, 2026, p. 6.

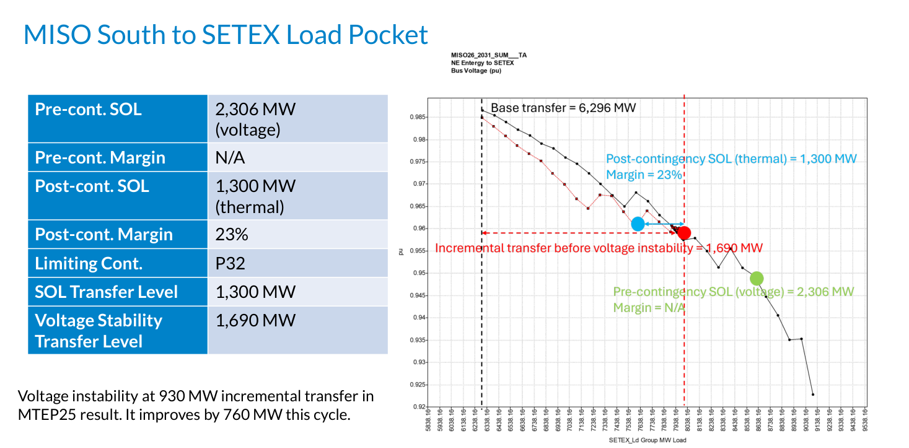

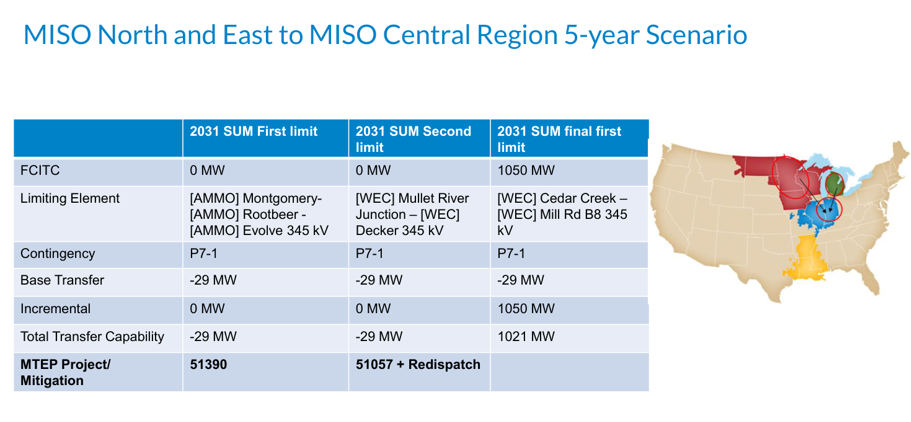

2. Voltage stability is not moving uniformly across the footprint

 Source: MISO, “MTEP26 Voltage Stability Analysis Results,” Planning Subcommittee, Sept. 2, 2026, p. 9.

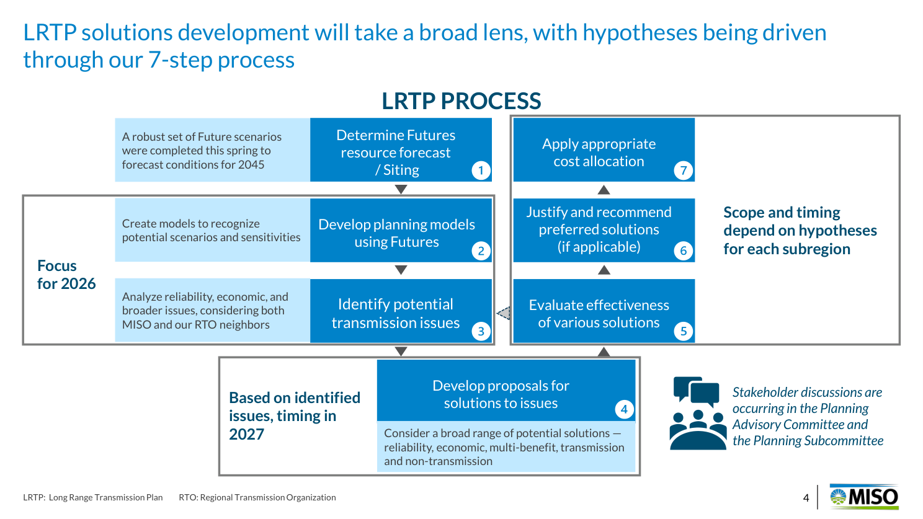

4. LRTP is moving from Futures into actual reliability-model building

What stakeholders should watch next

RMS Energy perspective
