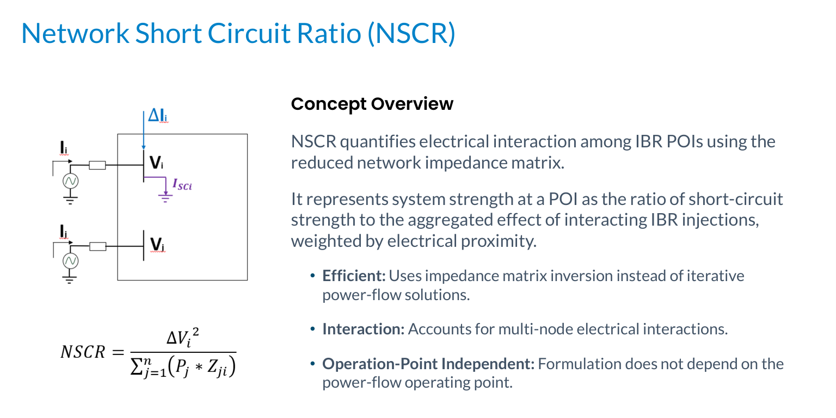

MISO’s Interconnection Reform Is Moving From Queue Volume to Study Quality

 Source: MISO, “Inverter Based Resource Performance, Modeling, and Conformance – System Strength Screening for EMT Studies,” IPWG, Sept. 1, 2026, p. 7.

2. The GIAA portal is being positioned as the project-data source of truth

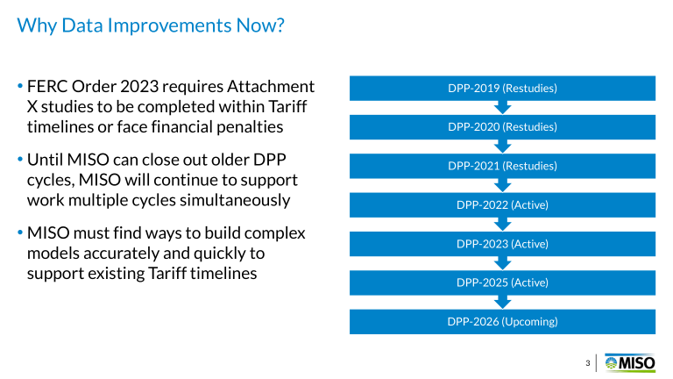

Figure 2. MISO is supporting multiple active and restudy DPP cycles simultaneously.

3. MISO is questioning whether every late withdrawal should trigger another full restudy

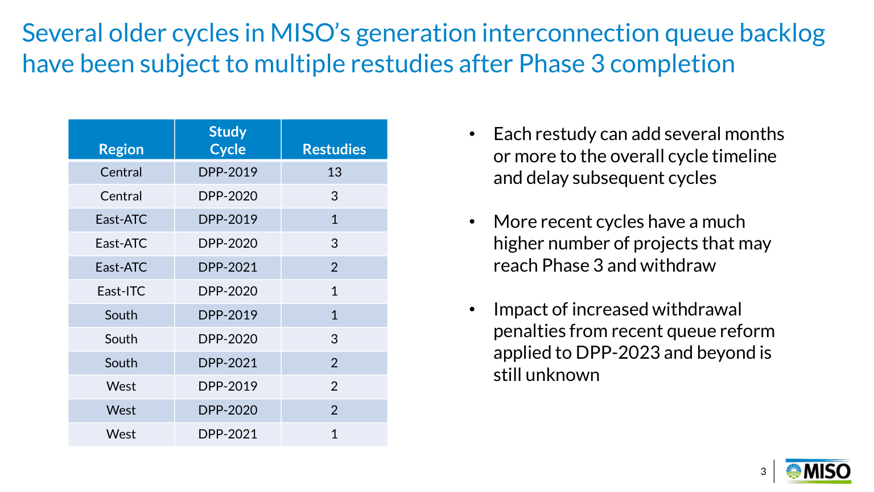

Figure 3. Restudy counts across older MISO DPP cycles.

Source: MISO, “Generator Interconnection Queue Improvements – Queue Cycle Restudy Process,” IPWG, Sept. 1, 2026, p. 3.

Feedback deadline: Sept. 16, 2026.

4. Storage developers are pushing for study assumptions that reflect how batteries actually operate

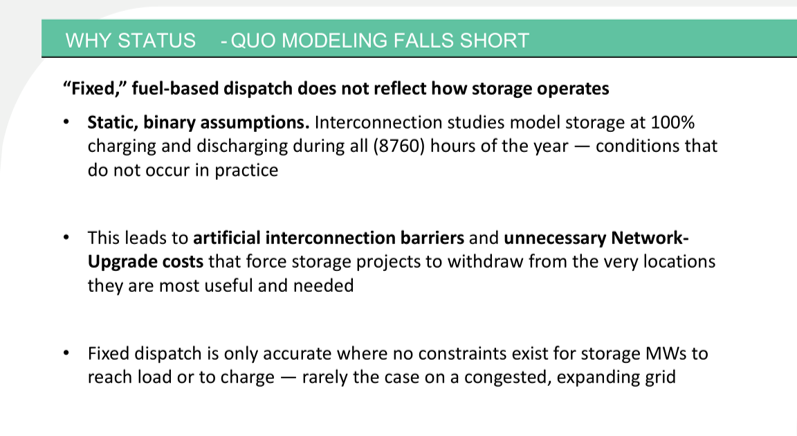

Figure 4. Stakeholder view of why fixed storage-dispatch assumptions can fall short.

Source: Spearmint Energy, “Enhancing Storage Modeling in MISO Interconnection & Planning Studies,” MISO IPWG, Sept. 1, 2026, p. 4.

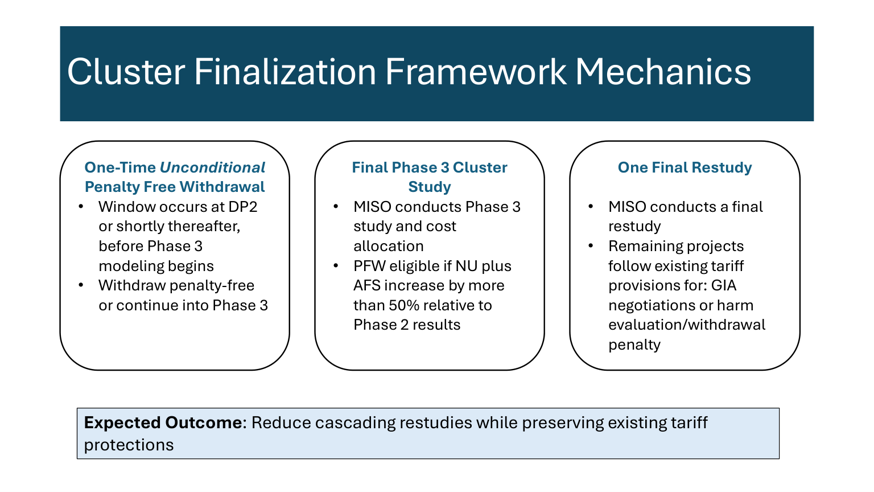

5. A separate stakeholder proposal targets the legacy backlog directly

What stakeholders should watch next

THE BIGGER QUESTION  Can MISO reduce queue time by improving study quality early enough that projects do not keep returning for new models, new assumptions, and new restudies?

RMS Energy perspective
