Large Load Interconnection Under MISO’s Proposed Large Load Addition Resource Study (LARS) Framework

How LARS Could Improve Interconnection Planning

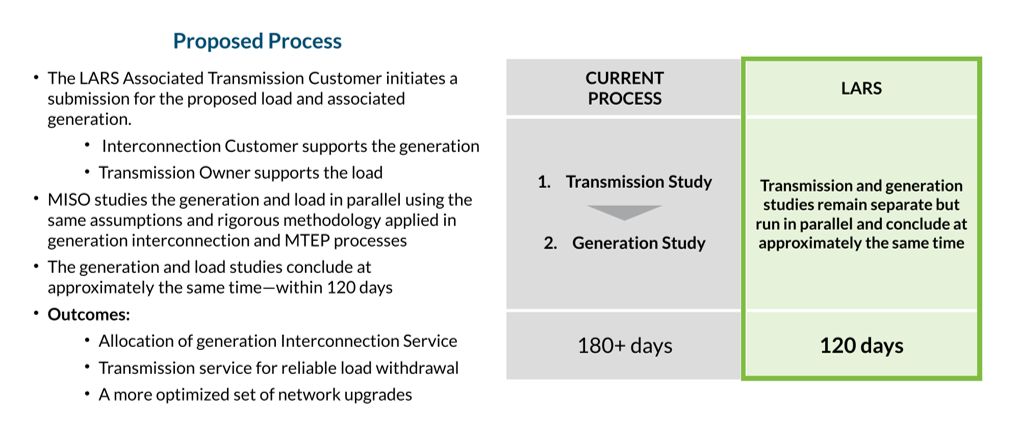

What the proposed process requires

Getting the Models Ready Before Submission

Study questionSeparate study riskCoordinated LARS focus
Network upgradesLoad and generator tracks may identify different needs or timing assumptions.Common violations and project impacts are evaluated together.
ContingenciesLoad-loss and generation-loss events may be treated inconsistently.Contingency development reflects facility design and credible loss events.

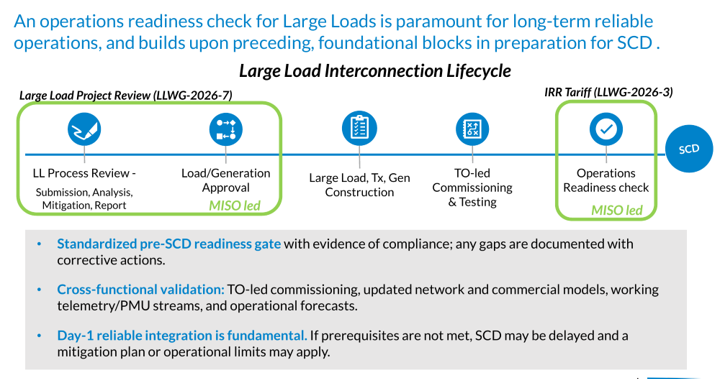

LARS is part of a broader large load lifecycle

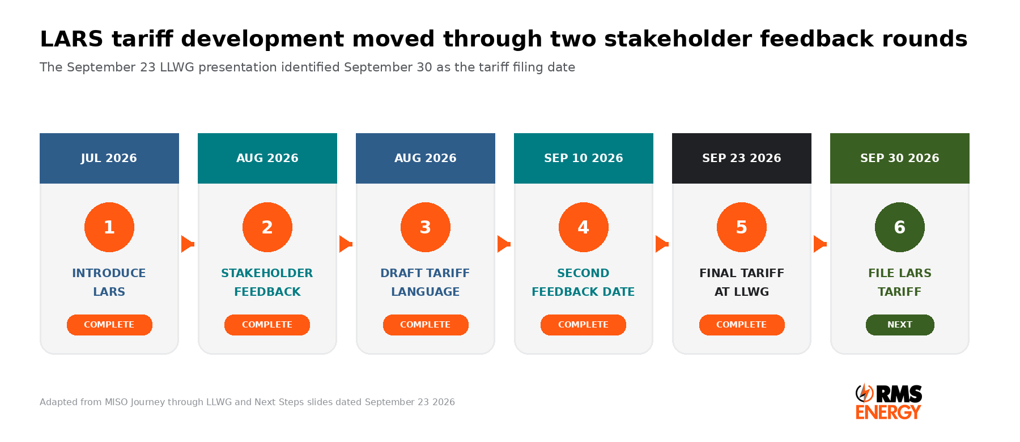

LARS Tariff Timeline and Next Steps

MISO introduced LARS in July, gathered stakeholder feedback twice, presented draft tariff language in August, and returned to LLWG on September 23 with final tariff language.

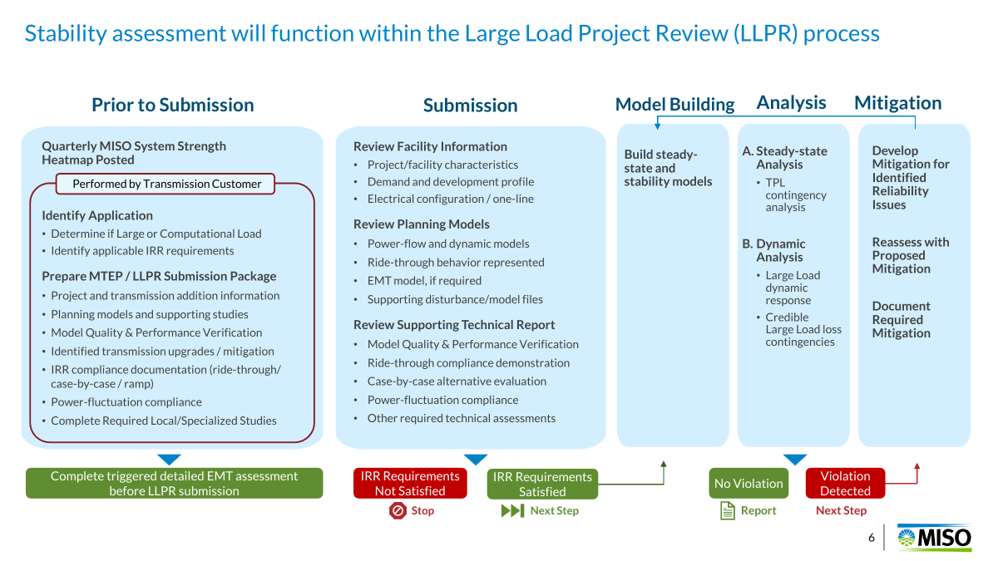

Stability Requirements Need to Be Addressed Early

Figure 4. Proposed stability assessment process for large-load projects. Source: MISO Large Load Working Group Stability Assessment presentation, September 23, 2026.

Where ZGIA fits

What developers should prepare now

RMS Energy Perspective

Conclusion
